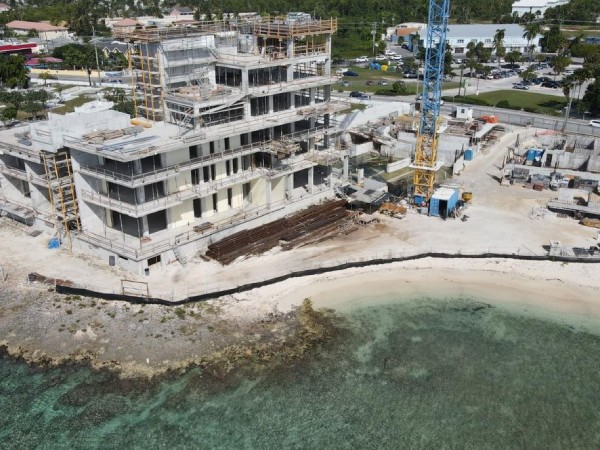

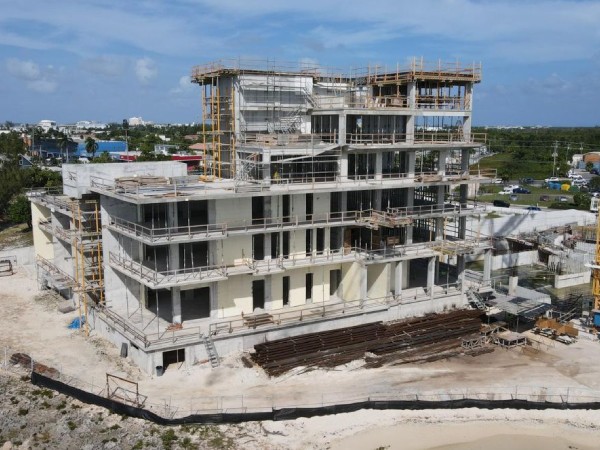

Construction on the Kailani site continues to move along at a steady pace. The Phase 2 structure has progressed to the 7th floor level and the team is continuing works on the Phase 3 basement. The fit out of the hotel’s model room is currently in process and ongoing.
PHASE 1
- This structure has been completed. The windows are currently on site and awaiting installation for further approval. The hardware for the windows has recently arrived.
- The arrival of the window/door installers is expected early 2022
- Construction of Phase 1’s concrete slab canopy over the entry doors has been complete
PHASE 2
- Concrete pour of the 7th floor roof slab is scheduled for pour during the first weeks of 2022
- The 3rd floor walls have been completed
- The staircase’s fire protection, electrical and plumbing works are roughed in up to the 7th floor level
- The model room’s stud framing is completed, and the unit is waterproofed
- Plumbing, electrical, mechanical and dry/wet fire protection rough-ins are all completed
- Both walls were boarded, and MEP inspections were approved for drywall installation on general walls and ceiling
- Staircase is completed up to the 7th floor roof level
- Metal framing has been completed in Units 202, 203, 204 and 205 (2nd floor)

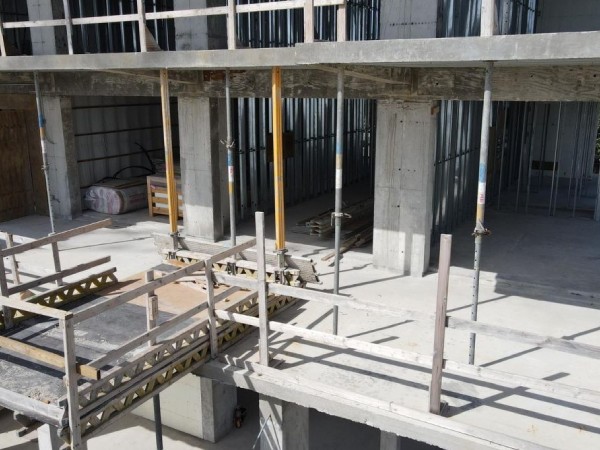

PHASE 3
- Plumbing was completed in the NW corner of the basement and inspection was approved
- Electrical main conduits were installed in the NW corner of the basement
- Floor drains and catch basins are in place and plumbing completed in the NW corner

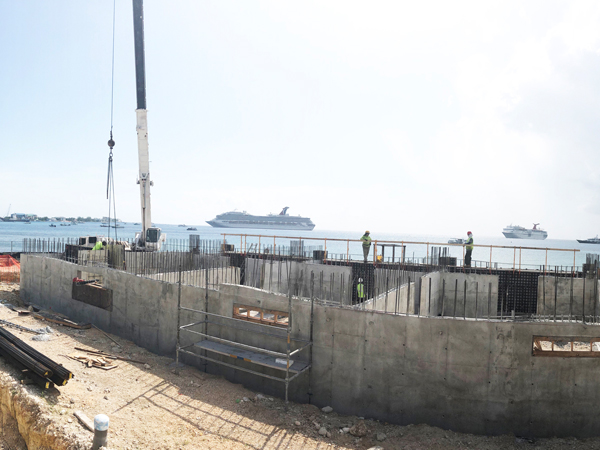

- A portion of the basement slab has been poured on the south side
- Recently poured concrete for strip footings in the NW corner of the basement and laced up the walls with rebar
- Poured concrete for the F8 bases along the NW corner
